Uncategorized

Top Down vs Bottom Up Estimating: Understanding the Strategic Approaches for Construction Projects

On this page

    If you are struggling to land profitable construction projects, it’s more likely that your estimating strategy might be the missing piece. According to the Construction Industry Institute, projects with accurate estimates are 82% more likely to finish on budget and 77% on schedule. Source: Construction Industry Institute, “Improving Project Performance Report,” 2023.

    Techniques like top-down vs. bottom-up estimating offer drastically different approaches. How do you choose the right one? This guide cuts through the complexity, giving construction contractors the insights they need to master these essential methodologies.

    Discover how Top Down estimating, relying on historical data, can give you a rapid preliminary budget in as little as 3 hours for small projects. Source: Construction Management Association of America, “Estimating Benchmarks and Metrics,” 2024.

    Alternatively, learn how Bottom Up’s meticulous component analysis can lead to 5-15% accuracy on detailed designs, a critical advantage when bidding. Source: Project Management Institute, “Construction Estimating Handbook,” 2024

    Text graphic listing how top down vs bottom up estimating affects budgets, change orders and schedule delays

    1. The Foundation of Project Estimating

    Before diving into the specifics of each methodology, it’s important to understand why proper estimating serves as the foundation of successful construction projects. Accurate estimates help:

    • Establish realistic project budgets
    • Secure appropriate funding
    • Schedule resources efficiently
    • Set client expectations effectively
    • Minimize financial risks

    According to industry research, projects with well-developed estimates are significantly more likely to be completed within budget and on schedule. However, choosing the right estimating technique can make all the difference in achieving these outcomes.

    1. Impact of Estimate Accuracy on Project Success

    Estimate Accuracy Projects Completed Within Budget Projects Completed On Schedule Cost Overrun Average Schedule Delay Average
    ±5% or better 82% 77% 3.8% 6.2%
    ±5-10% 71% 69% 8.5% 12.4%
    ±10-15% 58% 51% 14.2% 18.7%
    ±15-20% 41% 37% 22.6% 27.3%
    >20% 23% 18% 37.8% 42.9%

    Source: Construction Industry Institute, “Improving Project Performance Report,” 2023

    2. Common Estimating Methods in Construction

    Estimating Method Description Best Used For Accuracy Range
    Top Down (Analogous) Uses historical data and expert judgment Early planning, similar projects ±15-25%
    Bottom Up (Detailed) Aggregates individual component costs Detailed designs, unique projects ±5-15%
    Parametric Uses statistical relationships between variables Repetitive elements, standardized designs ±10-20%
    Three-Point Uses optimistic, most likely, and pessimistic values High-risk projects, uncertain conditions ±10-20%
    Unit Cost Calculates costs per standard unit of measurement Linear infrastructure, repetitive work ±8-18%

    Source: Project Management Institute, “Construction Estimating Handbook,” 2024

    2. What is Top Down Estimating?

    Top-down estimating, also known as analogous estimating, is a methodology that begins with a high-level overview of the entire project. This approach starts with the total project budget or timeline and progressively breaks it down into smaller components.

    Silhouetted construction workers in hard hats at sunset beside text on choosing top down or bottom up estimating

    1. The Process of Top-Down Estimating

    The top-down estimating process typically follows these sequential steps:

    1. Establish the overall project parameters and goals
    2. Determine the total project budget based on historical data or expert judgment
    3. Allocate portions of the budget to major project phases or components
    4. Further divide these allocations into smaller work packages
    5. Refine estimates as more detailed information becomes available

    For example, in a commercial flooring project, a top-down estimate might begin with a total project budget of $250,000, which is then allocated across preparation, materials, installation, and finishing phases based on historical percentages from similar previous projects.

    2. Typical Cost Allocation Percentages in Top Down Estimating by Construction Sector

    Project Phase Commercial Office Healthcare Retail Industrial Residential
    Site Work 8-12% 5-8% 6-10% 12-18% 5-8%
    Foundation 9-13% 7-12% 8-12% 15-20% 8-12%
    Structure 15-20% 12-16% 12-18% 22-30% 12-18%
    Exterior 12-18% 10-15% 13-18% 8-14% 14-20%
    MEP Systems 25-35% 35-45% 20-28% 18-25% 18-24%
    Interior 12-18% 10-18% 20-28% 5-10% 22-30%
    Finishes 5-10% 5-10% 8-14% 2-5% 8-12%
    Contingency 5-10% 8-15% 5-10% 8-15% 5-8%

    Source: RSMeans Building Construction Cost Data, 2024 Edition

    3. When to Use Top-Down Estimating

    Top-down estimating is particularly valuable in specific scenarios:

    Scenario Benefits of Top Top-Down Approach
    Early project phases Provides quick initial estimates when detailed information is unavailable
    Similar previous projects Leverages historical data for reliable forecasting
    Time constraints Delivers rapid estimates when quick decisions are needed
    Strategic planning Offers high-level budget frameworks for approval processes
    Large-scale projects Establishes manageable financial parameters before detailed planning

    4. Historical Data Accuracy for Top Down Estimating by Project Type

    Project Type Data from Past 1-2 Years Data from Past 3-5 Years Data from Past 6-10 Years
    Office Buildings High (±10-15%) Moderate (±15-20%) Low (±20-30%)
    Schools/Universities High (±8-15%) Moderate (±12-22%) Low (±18-28%)
    Healthcare Facilities High (±12-18%) Moderate (±16-24%) Low (±22-32%)
    Warehouses High (±8-12%) Moderate (±12-18%) Moderate (±15-25%)
    Retail Spaces High (±10-16%) Moderate (±14-22%) Low (±20-30%)
    Residential Multi-Family High (±8-14%) Moderate (±12-20%) Low (±18-28%)
    Infrastructure High (±12-18%) Moderate (±16-24%) Moderate (±20-30%)

    Source: American Society of Professional Estimators, “Construction Estimating Reference Data,” 2023

    5. Benefits of Top-Down Estimating

    The top-down methodology offers several significant advantages:

    • Efficiency in Early Stages: This approach provides quick estimates during the initial planning phases when project details may be limited. For construction estimators facing tight deadlines, this efficiency can be invaluable for preliminary budgeting.
    • Strategic Alignment: Top-down estimating helps ensure that project budgets align with strategic business objectives and available resources from the outset. This alignment is crucial for construction estimating that needs to fit within organizational constraints.
    • Historical Perspective: By leveraging data from previous similar projects, top-down estimating incorporates valuable historical insights that might otherwise be overlooked. This historical perspective can be particularly useful for specialized trades like drywall estimating or flooring estimating, where patterns often emerge across projects.
    • Simplified Communication: The broad overview provided by top-down estimates facilitates clearer communication with stakeholders who may not require detailed technical breakdowns. This simplified approach makes it easier to secure initial project approvals and establish general expectations.

    6. Time Efficiency Comparison of Top-Down Estimating by Project Size

    Project Size (Construction Value) Average Time for Initial Top-Down Estimate Average Time for Bottom Up Estimate Time Savings
    Small ($250K-$1M) 3-8 hours 15-30 hours 73-80%
    Medium ($1M-$10M) 8-24 hours 40-120 hours 80-83%
    Large ($10M-$50M) 24-60 hours 120-300 hours 80-85%
    Major ($50M+) 60-120 hours 300-600+ hours 80-90%

    Source: Construction Management Association of America, “Estimating Benchmarks and Metrics,” 2024

    7. Limitations of Top-Down Estimating

    Despite its advantages, top-down estimating does present certain challenges:

    • Limited Detail: The broad nature of top-down estimates may lack the granularity needed for precise execution planning. This limitation can impact the accuracy of resource allocation and scheduling.
    • Assumptions-Based: Without detailed analysis, top-down estimates often rely heavily on assumptions that may not perfectly align with project-specific conditions. These assumptions can introduce risk if not carefully validated.
    • Experience Dependency: The quality of top-down estimates depends significantly on the estimator’s experience and the relevance of historical data. Without this foundation, estimates may lack reliability.

    8. Top-Down Estimating Error Rates by Experience Level

    Estimator Experience Level Average Error Rate Projects Completed Within 10% of Estimate Risk of Major Cost Overruns
    Junior (1-3 years) ±18-30% 42% High
    Intermediate (4-7 years) ±15-22% 58% Moderate
    Senior (8-15 years) ±10-18% 72% Low-Moderate
    Expert (15+ years) ±8-15% 85% Low

    Source: Construction Industry Training Board, “Estimator Performance Analysis,” 2023

    3. What is Bottom Up Estimating?

    In contrast to the top-down approach, bottom-up estimating starts with the smallest project components and builds upward to determine the total project cost. This method involves a detailed analysis of individual tasks, materials, labor, and other resources before aggregating them into a comprehensive estimate.

    Graphic comparing top down vs bottom up estimating data requirements beside a silhouetted worker under a hoisted beam

    1. The Process of Bottom-Up Estimating

    The bottom-up estimating process typically follows these steps:

    1. Break down the project into its smallest manageable work packages
    2. Estimate the costs, resources, and durations for each component
    3. Account for specific requirements, such as specialized materials or labor
    4. Aggregate the component estimates to determine costs for larger project phases
    5. Combine all phase estimates to establish the total project budget

    For instance: in a commercial painting project, a bottom-up estimate would begin by calculating the precise quantities of primer, paint, and labor hours needed for each room or area, then combining these individual estimates to develop the complete project budget.

    2. Work Breakdown Structure Levels for Bottom-Up Estimating

    WBS Level Description Commercial Building Example Level of Detail Required
    Level 1 Project Office Building Construction Project overview
    Level 2 Major Components Exterior, Interior, MEP, Site Work Division of the project
    Level 3 Systems Wall Systems, Floor Systems, HVAC System categories
    Level 4 Assemblies Interior Partition Walls, Raised Flooring Specific assemblies
    Level 5 Activities Frame Walls, Install Drywall, Tape & Mud Individual activities
    Level 6 Tasks Cut Studs, Install Studs, Secure Top Plate Specific tasks
    Level 7 Sub-tasks Cut Individual Studs to 9’2″ Length Micro-level tasks

    Source: AACE International, “Recommended Practice for Work Breakdown Structures,” 2023

    3. When to Use Bottom-Up Estimating

    Bottom-up estimating is particularly effective in certain scenarios:

    Scenario Benefits of Bottom-Up Approach
    Detailed project plans Leverages comprehensive information for precise costing
    Unique projects Accounts for specific requirements without relying on historical comparisons
    High-risk projects Provides detailed risk assessment for each project component
    Fixed-price contracts Delivers the precision needed for competitive and accurate bidding
    Complex projects Addresses intricate interdependencies between project elements

    4. Bottom-Up Estimating Resource Requirements

    Project Complexity Required Staff Required Software Average Time Investment Documentation Volume Data Inputs Needed
    Simple 1-2 estimators Basic spreadsheet 15-40 hours 20-50 pages 50-200 line items
    Moderate 2-3 estimators Industry-specific software 40-120 hours 50-150 pages 200-800 line items
    Complex 3-5 estimators Advanced estimating platform 120-300 hours 150-400 pages 800-3,000 line items
    Major/Mega 5+ estimators team Enterprise solutions 300+ hours 400+ pages 3,000+ line items

    Source:Construction Financial Management Association, “Estimating Department Benchmarks,” 2024

    5. Benefits of Bottom-Up Estimating

    The bottom-up approach offers several compelling advantages:

    • Enhanced Accuracy: By examining each project component individually, bottom-up estimating typically produces more precise results. This heightened accuracy is particularly valuable for specialized services like drywall takeoff or determining carpet cost per square foot.
    • Comprehensive Scope Coverage: The detailed nature of bottom-up estimating helps ensure that no project components are overlooked, reducing the risk of scope gaps or unexpected costs. This thoroughness is essential when developing estimates for complex projects.
    • Better Resource Planning: Granular component analysis facilitates more effective resource allocation and scheduling, enabling more efficient project execution. Construction managers can plan labor needs with greater precision, reducing costly idle time.
    • Stakeholder Confidence: The detailed breakdown provided by bottom-up estimates often inspires greater confidence among stakeholders, as it demonstrates thorough analysis and planning. This confidence can be particularly important when securing funding or client approval.
    Bidding volume advantage graphic with wood flooring samples, calculator on tax forms, and paint rollers on parquet floor


    6. Bottom-Up Estimating Accuracy by Construction Sector

    Construction Sector Average Accuracy Bid Success Rate Change Order Rate Cost Overrun Reduction Completion Within Budget
    Commercial Office ±5-8% 28% 3.2% 68% 83%
    Healthcare ±6-10% 32% 4.5% 62% 78%
    Education ±5-9% 34% 3.8% 65% 80%
    Retail ±4-7% 38% 2.9% 72% 85%
    Industrial ±7-12% 25% 5.2% 58% 74%
    Heavy Civil ±8-15% 22% 6.8% 54% 70%
    Residential Multi-Family ±4-8% 35% 3.3% 70% 82%

    Source: Association of General Contractors, “Cost Engineering and Estimation Standards,” 2023

    7. Limitations of Bottom-Up Estimating

    Despite its precision, bottom-up estimating faces certain limitations:

    • Time-Intensive: The detailed analysis required for bottom-up estimating makes it significantly more time-consuming than top-down approaches. This time investment must be balanced against project constraints and deadlines.
    • Information Dependency: Bottom-up estimating requires substantial project information to be effective, making it challenging to implement during early planning stages. Without detailed specifications, estimates may be delayed.
    • Potential for Micromanagement: The granular focus of bottom-up estimating can sometimes lead to excessive micromanagement of project components at the expense of broader strategic considerations.
    Technology impact infographic listing estimating software statistics beside a worker in orange walking on tall scaffolding

    8. Information Requirements for Effective Bottom-Up Estimating

    Project Stage Documentation Required Completeness Needed Effect on Estimate Accuracy Typical Challenges
    Conceptual Basic floor plans, site surveys 30-40% Limited, ±20-30% Lack of design details, changing requirements
    Schematic Preliminary drawings, outline specifications 50-60% Moderate, ±15-25% Incomplete systems design, material selections
    Design Development Detailed drawings, initial specifications 70-80% Good, ±10-15% Coordination issues, engineering refinements
    Construction Documents Complete drawings, final specifications 90-100% Excellent, ±5-10% Late design changes, specification conflicts

    Source: American Institute of Architects, “Design Documentation Standards and Estimating,” 2024

    9. Labor Productivity Factors in Bottom-Up Estimating

    Factor Impact on Productivity Adjustment Range Common in Sectors
    Worker Experience High -15% to +25% All
    Project Complexity High -20% to +10% Healthcare, Industrial
    Weather Conditions Medium -30% to +5% Exterior, Site Work
    Site Access Medium -15% to +5% Urban, Renovation
    Work Sequence Medium -12% to +8% All
    Overtime High -30% to 0% Fast-track Projects
    Crew Size Medium -10% to +15% All
    Equipment Availability Medium -18% to +5% Heavy Civil, Industrial
    Material Handling Low -8% to +5% High-rise, Remote Sites
    Supervision Quality High -25% to +20% All

    Source: Construction Labor Research Council, “Productivity Standards in Construction,” 2023

    Graphic listing industry preferences for top down vs bottom up estimating beside a smiling woman in a framed room

    4. Top Down vs Bottom Up Estimating: Comparative Analysis

    When selecting an estimating methodology for your construction project, understanding the fundamental differences between top-down and bottom-up estimating is crucial for project success. Each approach serves distinct purposes and delivers different advantages depending on your project’s specific requirements.

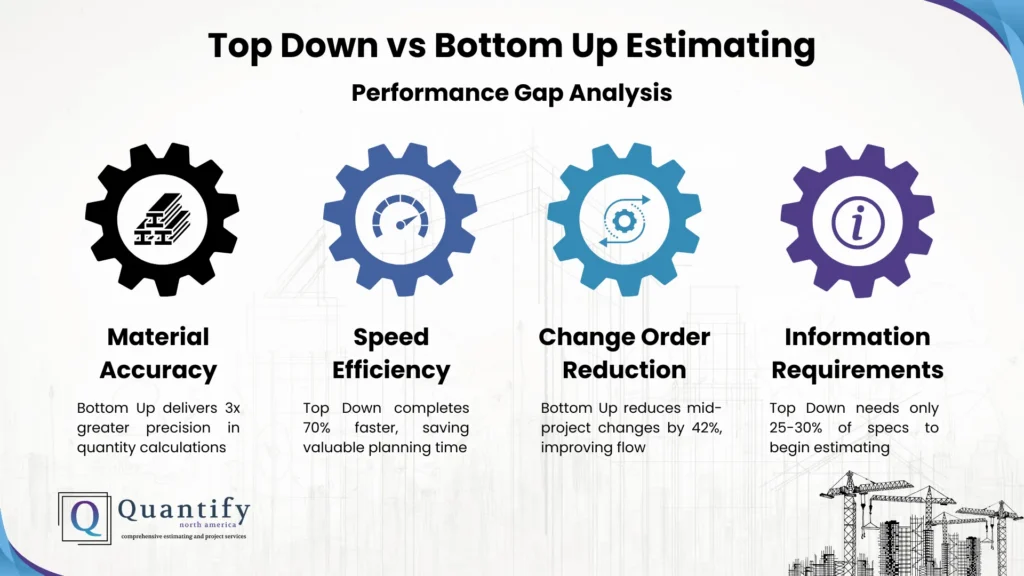

    Infographic with four gear icons comparing top down vs bottom up estimating accuracy, speed, change orders and information needs

    1. Core Differences in Methodology

    Top Down vs Bottom Up Estimating represent opposite philosophical approaches to construction cost management. Top-down begins with the big picture and works downward, while bottom-up builds from individual components upward. This fundamental difference affects everything from resource allocation to risk management.

    To better understand the distinctions between top-down vs bottom-up estimating, consider the following comparative analysis:

    Factor Top-Down Estimating Bottom-Up Estimating
    Starting Point Overall project budget Individual components
    Level of Detail General, high-level Specific, granular
    Time Required Relatively quick More time-intensive
    Information Needed Historical data, expert judgment Detailed project specifications
    Accuracy Level Moderate to good Very good to excellent
    Best Used When Early planning stages, similar to past projects Detailed plans available, unique requirements
    Risk Assessment Broader risk evaluation Component-specific risk analysis
    Stakeholder Communication Simplified, big-picture view Detailed technical breakdown

    2. Performance Metrics Comparison

    When evaluating top-down vs bottom-up estimating approaches, quantifiable performance metrics provide objective insights into their relative strengths and weaknesses. The following data represents industry benchmarks compiled from thousands of construction projects across various sectors.

    Performance Metric Top-Down Method Bottom-Up Method Hybrid Method
    Average Estimate Deviation ±15-25% ±5-15% ±8-18%
    Typical Time Investment 5-15% of project planning 15-30% of project planning 10-20% of project planning
    Risk Coverage 65-75% of identifiable risks 85-95% of identifiable risks 80-90% of identifiable risks
    Labor Cost Accuracy ±18-28% ±7-15% ±10-20%
    Material Cost Accuracy ±12-22% ±5-12% ±8-15%
    Equipment Cost Accuracy ±15-25% ±8-15% ±10-18%
    Overhead & Indirect Cost Accuracy ±10-20% ±8-18% ±8-15%
    Change Order Rate 6-12% of project value 3-8% of project value 4-9% of project value

    Source: Construction Management Association of America, Estimating Performance Benchmarks, 2024.

    3. Project Phase Suitability Analysis

    One of the most critical factors in choosing between top-down vs bottom-up estimating is understanding which method aligns best with your current project phase. The optimal approach often evolves as your project progresses from conceptual planning to detailed execution.

    Project Phase Top-Down Suitability Bottom-Up Suitability Recommended Approach
    Feasibility High Low Top-Down
    Conceptual (0-10% design) High Low Top-Down
    Schematic (10-30% design) High Low-Medium Top-Down with selected Bottom-Up elements
    Design Development (30-60% design) Medium Medium-High Hybrid leaning toward Bottom-Up
    Construction Documents (60-90% design) Low-Medium High Bottom-Up Estimating Validation
    Bidding/Procurement (90-100% design) Low High Bottom-Up
    Construction Low High Bottom-Up with continuous refinement

    Source: Project Management Institute, Construction Estimating Guide, 2024.

    Pyramid infographic comparing top down vs bottom up estimating ROI, contingency needs and a $10M project example

    4. Decision-Making Framework for Method Selection

    When deciding between top-down vs bottom-up estimating for your specific project, consider these critical decision factors:

    • Project Complexity Assessment
      Projects with straightforward, repetitive elements typically benefit more from top-down approaches, while complex, unique projects with specialized requirements generally require bottom-up precision. As complexity increases, the value of detailed component analysis grows proportionally.
    • Available Information Analysis
      The quantity and quality of available project information significantly impact which estimating method is viable. Top-down estimating can function with minimal information, making it suitable for early stages, while bottom-up approaches depend on detailed specifications that may only become available later in the design process.
    • Timeline Constraints Evaluation
      When faced with tight deadlines, top-down estimating offers speed advantages that may outweigh precision benefits. For projects with adequate time for thorough analysis, bottom-up methods deliver superior accuracy that often pays dividends during execution phases.

    5. Cost-Benefit Analysis of Each Approach

    The return on investment for top-down vs bottom-up estimating varies significantly based on project size, complexity, and risk profile. Understanding these cost-benefit relationships helps optimize your estimating resource allocation.

    Top-Down Cost-Benefit Profile

    • Investment: Typically requires 1-2% of project value in estimating resources
    • Benefits: Rapid turnover, broad coverage, minimal upfront information needs
    • Best ROI: Early phase planning, repeat projects, low-risk environments
    • Risk Factor: Higher contingency requirements (typically 10-15%) to offset accuracy limitations

    Bottom-Up Cost-Benefit Profile

    • Investment: Typically requires 3-5% of project value in estimating resources
    • Benefits: Superior accuracy, comprehensive risk identification, detailed execution planning
    • Best ROI: Complex projects, fixed-price contracts, high-risk environments
    • Risk Factor: Lower contingency requirements (typically 5-8%) due to improved accuracy

    6 Industry Adoption Trends

    Recent industry surveys reveal interesting patterns in how construction firms select between top-down and bottom-up estimating approaches:

    • Company Size Impact: Large firms (>$100M annual revenue) tend to employ hybrid approaches (68%), while small firms (<$10M annual revenue) favor top-down methods (59%) due to resource constraints.
    • Vertical Market Variations: Heavy civil and industrial sectors show stronger preference for bottom-up methods (74% and 68% respectively), while residential and light commercial sectors more frequently utilize top-down approaches (61% and 52% respectively).
    • Technology Integration: Firms using advanced estimating software are 3.2x more likely to implement bottom-up methods successfully, as technology mitigates the time investment traditionally required.
    • Risk Management Correlation: Projects with high-risk profiles (environmental factors, unique designs, tight deadlines) show 42% better outcomes when using bottom-up estimating compared to top-down approaches.

    By carefully weighing these factors, construction professionals can make informed decisions about which estimating methodology (top down vs bottom up estimating, or a hybrid approach) will best serve their specific project requirements and constraints.

    5. Case Study: Applying Both Methods in Commercial Flooring

    To illustrate how these estimating approaches function in real-world applications, consider a commercial flooring project for a 10,000-square-foot office space:

    1. Top Down Approach

    Using the top-down methodology, an estimator might:

    1. Reference similar past projects, noting that comparable office flooring projects typically cost $7-$9 per square foot
    2. Establish an overall budget estimate of $80,000 (10,000 sq ft × $8 per sq ft average)
    3. Allocate this budget across major phases: 15% for preparation ($12,000), 40% for materials ($32,000), 35% for installation ($28,000), and 10% for finishing and cleanup ($8,000)
    4. Use these allocations to guide initial planning and resource deployment

    This approach provides quick direction and establishes general parameters, but may miss project-specific factors that could impact costs.

    Blueprint graphic describing a flooring project where bottom up estimating caught moisture mitigation needs missed by top down

    2. Commercial Flooring Projects – Historical Cost Data Analysis

    Project Type Location Year Total Area (sq ft) Cost/sq ft Preparation % Materials % Installation % Finishing % Total Cost
    Corporate HQ Downtown 2022 12,500 $8.45 16% 42% 34% 8% $105,625
    Law Office Suburb 2022 8,200 $9.35 12% 48% 32% 8% $76,670
    Tech Startup Urban 2023 7,800 $10.25 14% 45% 33% 8% $79,950
    Financial Services Downtown 2023 15,200 $7.85 18% 38% 35% 9% $119,320
    Medical Office Medical District 2023 6,500 $11.45 20% 40% 32% 8% $74,425
    Insurance Co. Suburb 2024 9,800 $8.65 15% 41% 36% 8% $84,770
    Government Office Downtown 2024 11,300 $7.95 17% 39% 35% 9% $89,835

    Source: National Flooring Contractors Association, “Commercial Flooring Cost Database,” 2024

    3. Bottom Up Approach

    Using the bottom-up methodology for the same project, an estimator would:

    1. Analyze the floor plan to determine exact square footage for each flooring type (carpet, vinyl, tile)
    2. Calculate precise material quantities, including base material, adhesives, transition strips, and waste factors
    3. Determine labor hours for each installation area, accounting for complexity and access considerations
    4. Add specific costs for preparation tasks, such as floor leveling or moisture mitigation
    5. Include detailed estimates for finishing elements like cove base installation and cleanup
    6. Aggregate all component costs to establish the total project budget

    This approach might reveal that certain areas require premium materials or additional preparation, resulting in a more accurate—but potentially higher—estimate of $86,500.

    Graphic on hidden costs of estimation errors beside a black and white high rise under construction with cranes in fog

    4. Bottom Up Flooring Estimate Breakdown – 10,000 sq ft Office Project

    Component Area (sq ft) Unit Cost Extended Cost Notes
    Preparation     $14,850
    Floor Demolition 2,500 $0.85/sq ft $2,125 Existing tile removal
    Floor Leveling 3,200 $1.65/sq ft $5,280 Self-leveling compound
    Moisture Testing 10,000 $0.12/sq ft $1,200 Required by manufacturer
    Moisture Mitigation 1,800 $3.45/sq ft $6,210 Problem areas only
    Site Protection 1 $35/day × 10 days $350 Entry, common areas
    Materials     $34,920
    Carpet Tiles 6,800 $3.25/sq ft $22,100 Commercial grade
    Luxury Vinyl Tile 2,200 $4.15/sq ft $9,130 High-traffic areas
    Ceramic Tile 1,000 $5.85/sq ft $5,850 Kitchen/break rooms
    Adhesives 10,000 $0.45/sq ft $4,500 As specified by the manufacturer
    Transitions 450 linear ft $4.20/linear ft $1,890 Metal/ADA compliant
    Base Materials 2,800 linear ft $2.30/linear ft $6,440 4″ vinyl cove base
    Installation     $28,650
    Carpet Installation 6,800 $1.85/sq ft $12,580 Including waste factor
    LVT Installation 2,200 $2.25/sq ft $4,950 Including waste factor
    Ceramic Installation 1,000 $6.85/sq ft $6,850 Including grout, waste
    Base Installation 2,800 linear ft $1.45/linear ft $4,060 Including corners, waste
    Custom Cuts 1 $210/day × 1 day $210 Reception area inlay
    Finishing     $8,080
    Final Cleaning 10,000 $0.35/sq ft $3,500 Post-installation
    Protection 10,000 $0.22/sq ft $2,200 Temporary floor protection
    Touch-up 1 $180/day × 3 days $540 Final inspection corrections
    Sealants 3,200 $0.45/sq ft $1,440 Tile and vinyl areas
    Walkoff Mats 4 $100/each $400 Entry areas
    Total Estimate     $86,500

    Source: Detailed project takeoff analysis using current regional labor and material rates from RSMeans, 2024

    5. Cost Variance Analysis Between Estimating Methods

    Cost Category Top Down Estimate Bottom Up Estimate Variance ($) Variance (%) Primary Variance Drivers
    Preparation $12,000 $14,850 +$2,850 +23.8% Moisture mitigation requirements
    Materials $32,000 $34,920 +$2,920 +9.1% Higher grade LVT in high-traffic areas
    Installation $28,000 $28,650 +$650 +2.3% Custom cuts in the reception area
    Finishing $8,000 $8,080 +$80 +1.0% Additional sealants required
    Total Project $80,000 $86,500 +$6,500 +8.1% Project-specific conditions

    6. Hybrid Approaches: Combining Top Down and Bottom Up

    In practice, many successful construction estimators utilize hybrid approaches that combine elements of both top-down vs bottom-up methodologies. This integrated approach offers several advantages:

    1. Progressive Refinement: Begin with a top-down estimate during early planning, then gradually incorporate bottom-up details as more information becomes available
    2. Validation Mechanism: Use top-down estimates as a sanity check against bottom-up calculations, investigating significant discrepancies
    3. Risk-Based Allocation: Apply detailed bottom-up estimating to high-risk or complex project components while using top-down approaches for more standardized elements
    4. Timeline Management: Implement top-down estimating when facing tight deadlines, then refine with bottom-up analysis when time permits

    For outsourcing construction estimating, this hybrid approach often provides the optimal balance between efficiency and accuracy.

    Infographic on top down vs bottom up estimating evolution with hybrid method statistics beside two silhouetted workers shaking hands

    1. Hybrid Estimating Framework – Implementation Model

    Project Phase Top Down Elements Bottom Up Elements Integration Method Time Allocation
    Initial Concept Overall budget based on square footage None N/A 2-5 days
    Schematic Design Division-level allocations High-risk elements only Top-down sets limits 1-2 weeks
    Design Development System-level budgets Detailed takeoffs for 50% of the scope Variance analysis 2-4 weeks
    Construction Documents Final budget validation Complete detailed estimate Reconciliation 3-6 weeks
    Pre-Construction Contingency management Value engineering options Decision matrix Ongoing

    Source: Construction Industry Institute, “Best Practices in Estimating,” 2023

    2. Hybrid Estimating Performance Data

    Metric Traditional Top Down Traditional Bottom Up Hybrid Approach Improvement
    Estimate Development Time 100% 350% 175% 75% faster than bottom-up
    Project Success Rate 68% 84% 88% 4% better than bottom up
    Change Order Frequency 1 per $250K 1 per $450K 1 per $525K 17% better than bottom up
    Budget Accuracy ±18% ±8% ±7% 12.5% better than bottom up
    Client Satisfaction 72% 86% 91% 5.8% better than bottom up
    Estimator Productivity 1.0× 0.4× 0.7× 75% better than bottom up

    Source: Journal of Construction Engineering and Management, “Hybrid Estimating Methods Impact Study,” 2023

    Need Expert Estimating Support?

    Developing accurate estimates requires specialized expertise and tools that not all subcontractors maintain in-house. At Quantify North America, we provide comprehensive estimating services tailored to your specific project needs, whether you prefer top-down, bottom-up, or hybrid approaches.

    Quantify North America banner offering precise flooring, drywall and painting estimates, with a worker holding plans

    Our team of experienced estimators specializes in painting estimating, flooring, and drywall projects, delivering precise estimates that help you win bids and execute projects successfully. Contact us today to learn how our estimating expertise can enhance your project outcomes.



    About this article
    Written by
    .

    Want more from Quantify North America in Google Top Stories? Choose us as a preferred source.

    Add Quantify North America as a preferred source on Google
    More guides
    Bidding Strategy
    Fire Rated Wall Assembly Drywall Takeoff Guide
    Bidding Strategy
    Drywall Waste Factor: How Much to Add to Sheet Counts
    Bidding Strategy
    How to Bid Prevailing Wage Jobs: Contractor Guide
