Three Point Estimating: Definition and Examples

On this page

    Accuracy in cost estimation makes all the difference between profit and loss in construction projects, and three-point estimating has proven itself as a reliable methodology that helps contractors handle uncertainty while creating more dependable projections.

    With so much variability in today’s economy, prices change quickly, making estimating tricky. This has put a strain on more popular estimating techniques like analogous and parametric estimating. Three-point estimating stands out as a reliable methodology that helps contractors manage uncertainty while producing more dependable projections.This strategic advantage particularly helps mid-sized contractors manage multiple projects with limited resources. To turn those probability ranges into a go or no-go call, pair them with a practical bid no-bid decision framework that weighs risk alongside fit and capacity.

    In this article, we will take a look at how three-point estimating can benefit construction businesses, especially mid-sized commercial contractors looking for good estimating services for tasks like painting, flooring, and drywall. We will also take a quick look at practical insights and examples from real-world applications.

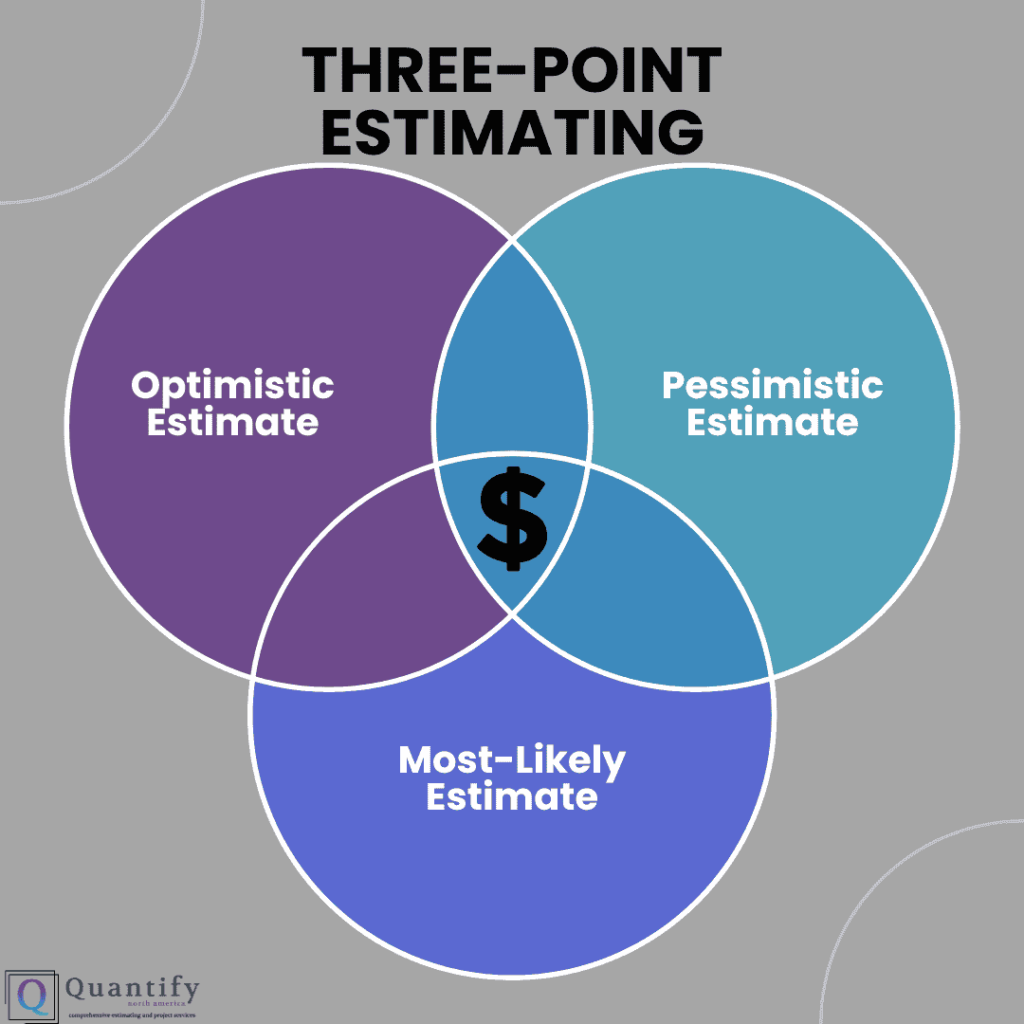

    Venn diagram of three point estimating showing optimistic, pessimistic and most likely estimates around a dollar sign

    What is Three-Point Estimating?

    Three-point estimating functions as a project management technique that utilizes three separate estimates to create an approximate range for a project’s cost, duration, or resource requirements. Single-point estimates carry a significant risk of inaccuracy, while this method recognizes uncertainty by examining multiple possible outcomes.

    The three estimates used in this technique include:

    1. Optimistic estimate (O): The best-case scenario with everything proceeding perfectly. This represents the minimum possible time or cost under ideal conditions.
    2. Most likely estimate (M): The realistic scenario based on normal conditions and typical challenges. This is like looking at the analogous estimate of a job using similar previous projects.
    3. Pessimistic estimate (P): The worst-case scenario that accounts for potential problems, delays, and unforeseen complications. This shows the maximum time or cost if significant challenges occur.

    These three values combine mathematically to calculate a weighted average, creating a more realistic estimate that accounts for uncertainty while properly weighting the most probable outcome.

    Mathematical Foundation

    Three-point estimating works with an aggregate system like the central limit theorem. It typically uses one of two mathematical formulas to calculate the expected estimate:

    1. Triangular Distribution

    This straightforward approach calculates a simple average of the three estimates:

    E = (O + M + P) / 3

    Where:

    • E = Expected estimate
    • O = Optimistic estimate
    • M = Most likely estimate
    • P = Pessimistic estimate

    2. Beta Distribution (PERT)

    The Program Evaluation and Review Technique (PERT) applies a weighted average that gives greater influence to the most likely estimate:

    E = (O + 4M + P) / 6

    Where:

    • E = Expected estimate
    • O = Optimistic estimate
    • M = Most likely estimate (weighted four times)
    • P = Pessimistic estimate

    Construction estimating commonly uses the PERT formula because it places greater emphasis on the most likely scenario while still considering the best and worst cases.

    Three-point estimating also allows the calculation of standard deviation and variance, providing statistical insights into risk and uncertainty levels:

    Standard Deviation = (P – O) / 6 Variance = [(P – O) / 6]²

    These calculations help quantify the uncertainty in your estimates, supporting better risk management and contingency planning.

    Why Construction Contractors Should Use Three Point Estimating

    Here are some of the core benefits of using three-point estimating for your construction projects:

    Improved Accuracy

    The core benefit of three-point estimating comes from enhanced accuracy. A study by the Construction Industry Institute found that traditional single-point estimates typically deviate from actual costs by 25-50%, while three-point estimates reduce this variance to 10-20%.

    Commercial contractors working in specialized sectors like healthcare or institutional construction need this precision for both profitability and client satisfaction.

    Better Risk Management

    Three-point estimating naturally incorporates risk analysis by considering worst-case scenarios. This helps contractors:

    • Spot potential problem areas before they emerge
    • Create mitigation strategies for high-risk components
    • Assign appropriate contingency funds
    • Set realistic client expectations

    Enhanced Communication and Transparency

    Using three-point estimates facilitates clearer communication with clients and stakeholders through:

    • Presenting estimate ranges rather than fixed numbers
    • Explaining the confidence level of various projections
    • Showing thoroughness in the estimating process
    • Providing data-driven justifications for contingency funds

    This transparency builds client trust and minimizes disputes over change orders or timeline adjustments.

    Improved Decision Making

    The statistical insights from three-point estimating support smarter business decisions:

    • Bid/no-bid decisions based on risk assessment
    • Resource allocation across multiple projects
    • Schedule optimization based on probability analysis
    • Strategic pricing based on confidence intervals

    This strategic advantage particularly helps mid-sized contractors manage multiple projects with limited resources.

    Implementing Three-Point Estimating: A Step-by-Step Process

    Step 1: Break Down the Project

    Start by dividing the project into manageable components using a Work Breakdown Structure (WBS). Construction projects typically include:

    • Site preparation
    • Foundation work
    • Structural elements
    • Mechanical systems
    • Electrical systems
    • Plumbing
    • Interior finishes
    • External works

    More detailed breakdowns lead to more accurate final estimates. Early project phases often begin with Rough Order of Magnitude (ROM) estimates that typically have accuracy ranges of -25% to +75%, making three-point estimating especially valuable for quantifying this uncertainty.

    Step 2: Gather Historical Data

    Collect relevant data from similar past projects, including:

    • Actual costs vs. estimated costs
    • Material usage and prices
    • Labor productivity rates
    • Duration of similar activities
    • Previous challenges and delays

    This historical information creates a solid foundation for your three-point estimates.

    Step 3: Determine the Three Points for Each Component

    For what really makes it a three-point estimating system, you need to identify the following elements in your breakdown:

    Optimistic (O): The best possible outcome. Consider:

    • Ideal conditions
    • Maximum efficiency
    • No delays or disruptions
    • Lowest reasonable material costs

    Most Likely (M): The realistic scenario. Consider:

    • Normal working conditions
    • Typical productivity
    • Standard lead times
    • Current market prices

    Pessimistic (P): The worst-case scenario. Consider:

    • Adverse weather conditions
    • Supply chain disruptions
    • Labor shortages
    • Material price increases
    • Complex site conditions
    • Regulatory complications

    Step 4: Calculate Expected Values

    Apply either the triangular distribution formula (O + M + P) / 3 or the PERT formula (O + 4M + P) / 6 to each component. Construction estimating usually benefits more from the PERT formula’s reliability.

    Step 5: Calculate Standard Deviation and Variance

    For each component, determine:

    • Standard Deviation = (P – O) / 6
    • Variance = [(P – O) / 6]²

    These calculations quantify uncertainty and risk.

    Step 6: Combine Component Estimates

    Add the expected values of all components to get the overall project estimate.

    To determine the overall project variance, add the variances of individual components. The standard deviation of the entire project equals the square root of this combined variance.

    Step 7: Establish Confidence Intervals

    Using the standard deviation, you can calculate confidence intervals for your estimate:

    • 68% confidence interval: Expected Value ± 1 Standard Deviation
    • 95% confidence interval: Expected Value ± 2 Standard Deviations
    • 99% confidence interval: Expected Value ± 3 Standard Deviations

    These intervals help communicate the range of possible outcomes to stakeholders.

    Real-World Example: Retail Space Renovation

    Here’s how three-point estimating applies to a retail space renovation project:

    ComponentOptimistic (O)Most Likely (M)Pessimistic (P)Expected (PERT)
    Demolition$15,000$18,000$25,000$18,667
    Structural Modifications$22,000$28,000$42,000$29,333
    HVAC Upgrades$35,000$42,000$60,000$43,833
    Electrical Work$28,000$32,000$45,000$33,500
    Plumbing$12,000$15,000$22,000$15,667
    Interior Finishes$45,000$50,000$65,000$51,667
    Fixtures & Equipment$30,000$35,000$48,000$36,333
    TOTAL$187,000$220,000$307,000$228,999

    Standard Deviation Calculation:

    • Project Standard Deviation = √(Sum of Component Variances)
    • = √([(25,000-15,000)/6]² + [(42,000-22,000)/6]² + … + [(48,000-30,000)/6]²)
    • = √(2,778² + 3,333² + … + 3,000²)
    • = √(58,642,361)
    • ≈ $7,658

    Confidence Intervals:

    • 68% confidence: $228,999 ± $7,658 ($221,341 to $236,657)
    • 95% confidence: $228,999 ± $15,316 ($213,683 to $244,315)

    This analysis gives the contractor a statistically sound estimate range to present to the client, rather than a single number that creates false expectations.

    Pros of Three-Point Estimating

    1. Improved accuracy: By incorporating multiple scenarios, three-point estimating produces more reliable results than single-point methods.
    2. Better risk management: The method naturally accounts for uncertainty, allowing for appropriate contingency planning.
    3. Statistical insights: Calculating standard deviation and variance provides quantifiable risk metrics.
    4. Enhanced communication: Presenting estimates as ranges with confidence levels sets realistic expectations with clients.
    5. Adaptability: The approach works for cost, schedule, and resource estimating across various project types.

    Cons of Three-Point Estimating

    1. Time-intensive: Creating three estimates instead of one requires additional effort, especially for complex projects with many components.
    2. Data requirements: Effective implementation needs historical data and experienced judgment to set realistic ranges.
    3. Potential for bias: Estimators may unconsciously narrow or widen ranges based on personal risk tolerance or client expectations. A technique like the Delphi method enhances three-point estimating by reducing individual bias.
    4. Mathematical complexity: Some team members resist adoption due to the statistical calculations involved.
    5. False precision: The mathematical formulas sometimes create an impression of scientific accuracy that masks the subjective nature of the input estimates.

    Best Practices for Construction Contractors

    To get the most from three point estimating in your construction business:

    1. Build a historical database: Systematically collect and organize data from past projects to inform future estimates.
    2. Standardize your approach: Develop consistent protocols for generating optimistic, most likely, and pessimistic estimates.
    3. Train your team: Make sure estimators understand the statistical concepts and can explain them to stakeholders.
    4. Use visualization tools: Present results graphically to help clients and team members grasp the probability distributions.
    5. Review and recalibrate: After project completion, compare actual results with estimates to improve future projections.
    6. Consider Monte Carlo simulation: For larger projects, supplement three-point estimating with Monte Carlo analysis for more comprehensive risk assessment.
    7. Integrate with scheduling: Apply three-point estimates to cost and duration estimates for integrated cost-schedule risk analysis.

    When to Use Three Point Estimating

    Three point estimating works particularly well in situations involving:

    • High-stakes projects where accuracy matters most
    • New project types with limited historical data
    • Projects with significant identified risks
    • Fixed-price contracts where margin protection becomes essential
    • Projects in volatile markets with uncertain material costs
    • Competitive bidding scenarios requiring precision

    For routine, small-scale, or highly predictable projects, the additional effort may not pay off.

    Tools and Software for Three Point Estimating

    Several digital tools streamline the three point estimating process:

    1. Microsoft Excel: Custom templates with built-in PERT formulas and standard deviation calculations make implementation easier.
    2. Oracle Primavera Risk Analysis: This sophisticated tool handles integrated cost-schedule risk modeling using three point estimates.
    3. @RISK by Palisade: This Excel add-in supports Monte Carlo simulation based on three point estimates.
    4. ProjectLibre: Open-source project management software includes PERT analysis capabilities.
    5. ProEst: Construction-specific estimating software features risk analysis tools.

    These tools significantly reduce the mathematical burden while providing advanced visualization and reporting capabilities.

    Quantify North America ad with estimating accuracy stats beside a hand drawing on paper with a yellow pencil

    How Quantify North America Can Help

    Implementing three-point estimating requires expertise and historical data that many contractors lack in-house. Quantify North America specializes in professional estimating services tailored to mid-sized commercial contractors in retail, healthcare, and institutional sectors.

    Our experienced estimators can:

    • Implement three point estimating methodology customized to your specific project needs
    • Provide statistical analysis of estimated uncertainty and risk
    • Develop confidence intervals to support your bidding strategy
    • Create visualizations that effectively communicate estimate ranges to clients
    • Train your team on three point estimating techniques

    We know you face estimator shortages, manage multiple bids simultaneously, and continuously work to enhance estimating accuracy. Quantify North America offers the expertise and resources needed to implement three-point estimating effectively. Contact US  today to learn how our professional estimating services can help you implement three point estimating and secure more profitable projects.

    About this article
    Written by
    .

    Want more from Quantify North America in Google Top Stories? Choose us as a preferred source.

    Add Quantify North America as a preferred source on Google
    More guides
    Bidding Strategy
    Fire Rated Wall Assembly Drywall Takeoff Guide
    Bidding Strategy
    Drywall Waste Factor: How Much to Add to Sheet Counts
    Bidding Strategy
    How to Bid Prevailing Wage Jobs: Contractor Guide
